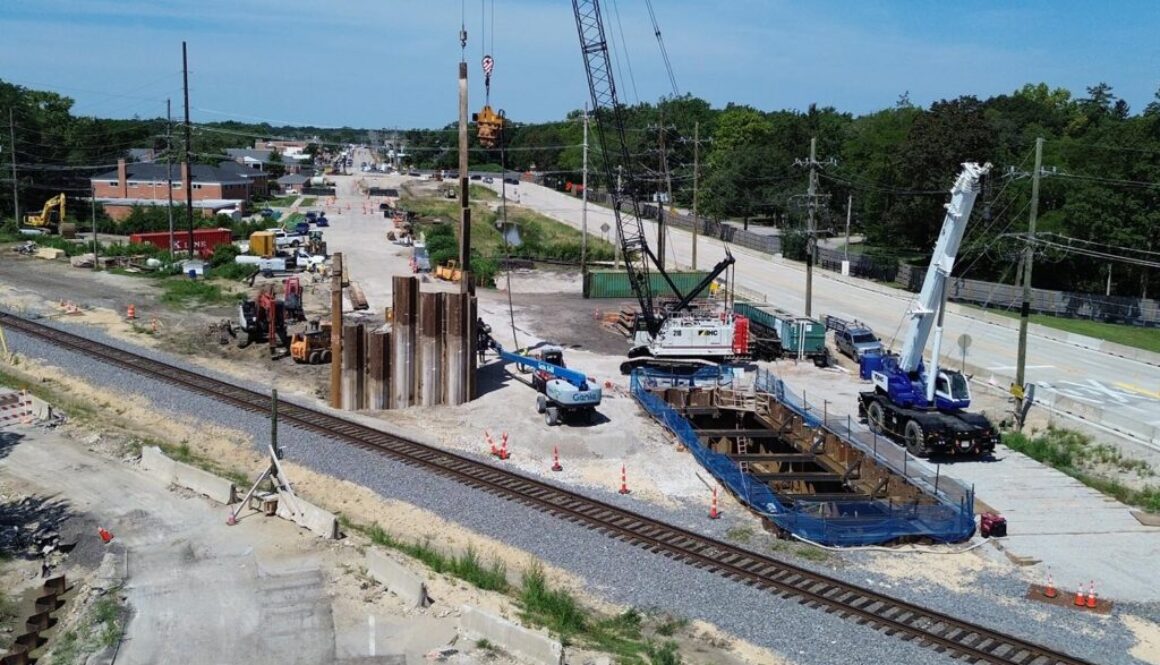

Project Update – September 21, 2026

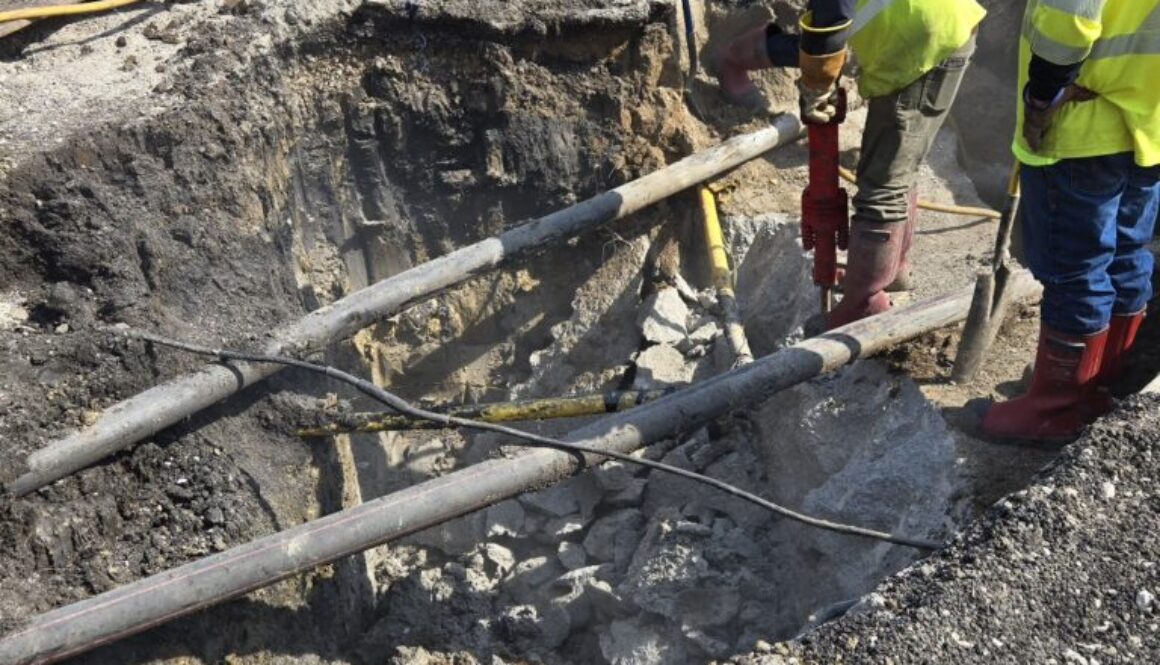

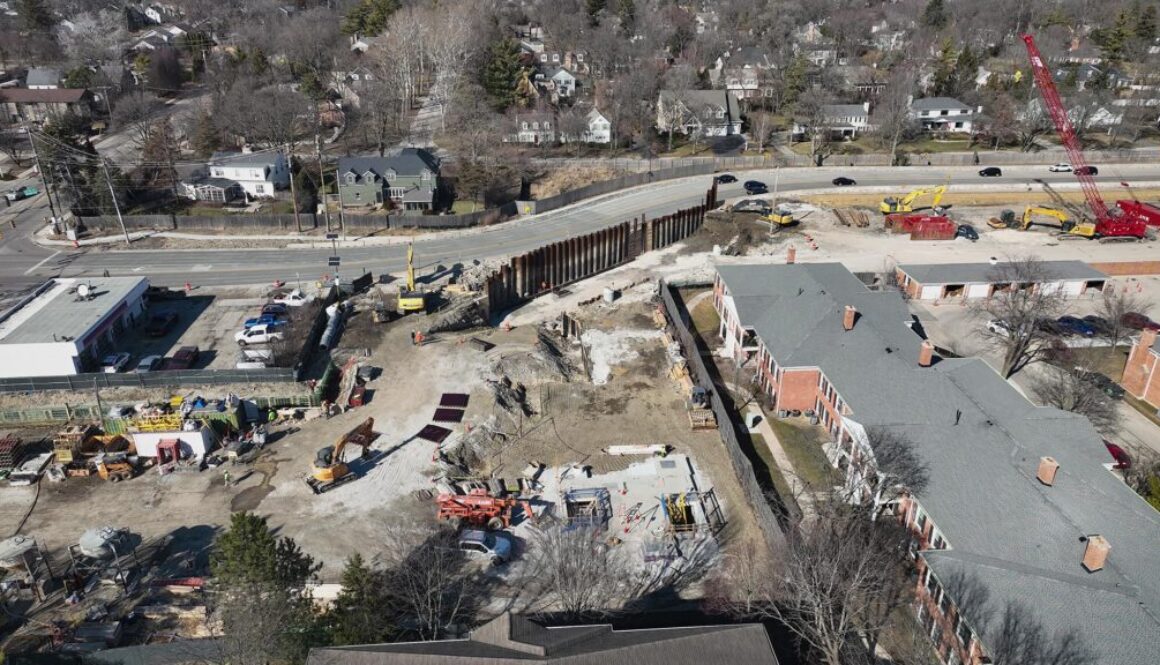

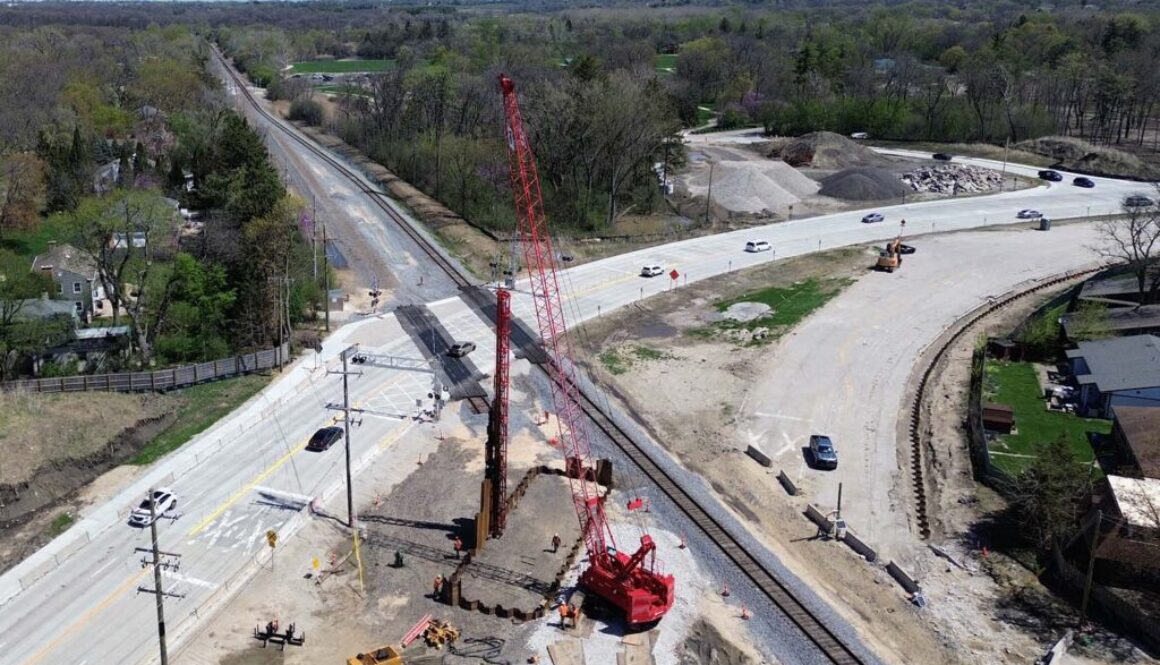

Over the past two months, crews have coordinated the following work: Railroad bridge construction. Crews completed the footing for the north bridge abutment (the structural […]
....
Skip to content
Over the past two months, crews have coordinated the following work: Railroad bridge construction. Crews completed the footing for the north bridge abutment (the structural […]

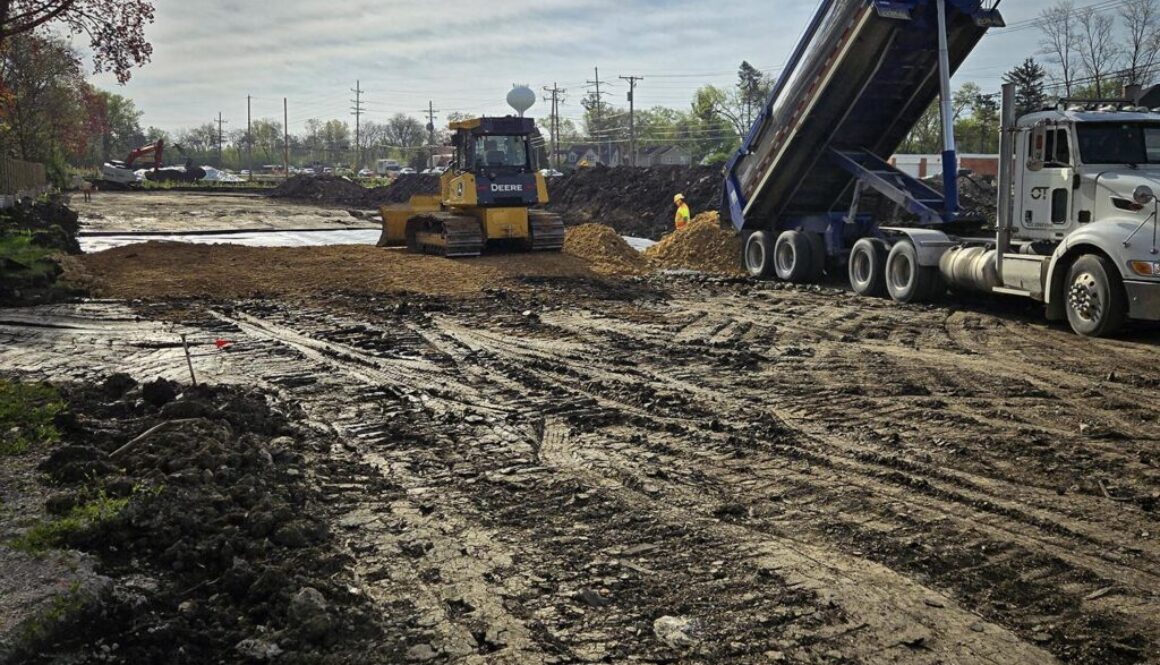

Through June and July 2026 crews have completed the following work: Completed the Route 14 culvert, a storm sewer that will carry the relocated Flint […]

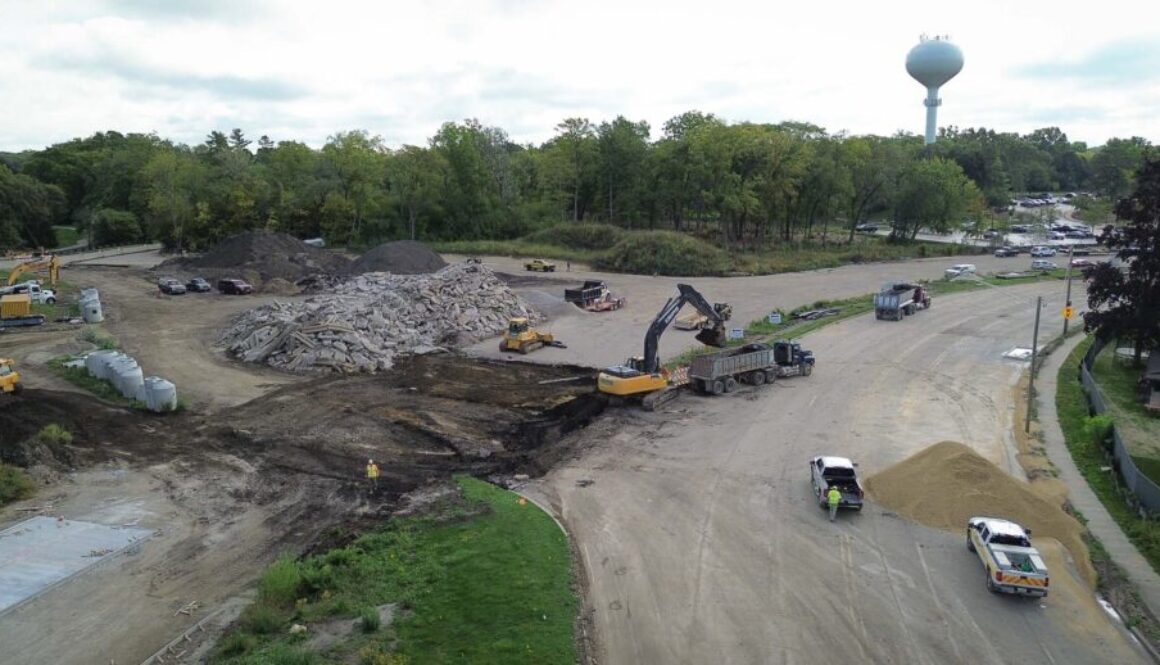

The contractor has completed the installation of a new storm sewer and water main under the Canadian National railroad track, including making a connection to […]
Construction activity has ramped back up over the past month, with crews completing the following work: Completed the walls and bottom of the Route 14 […]

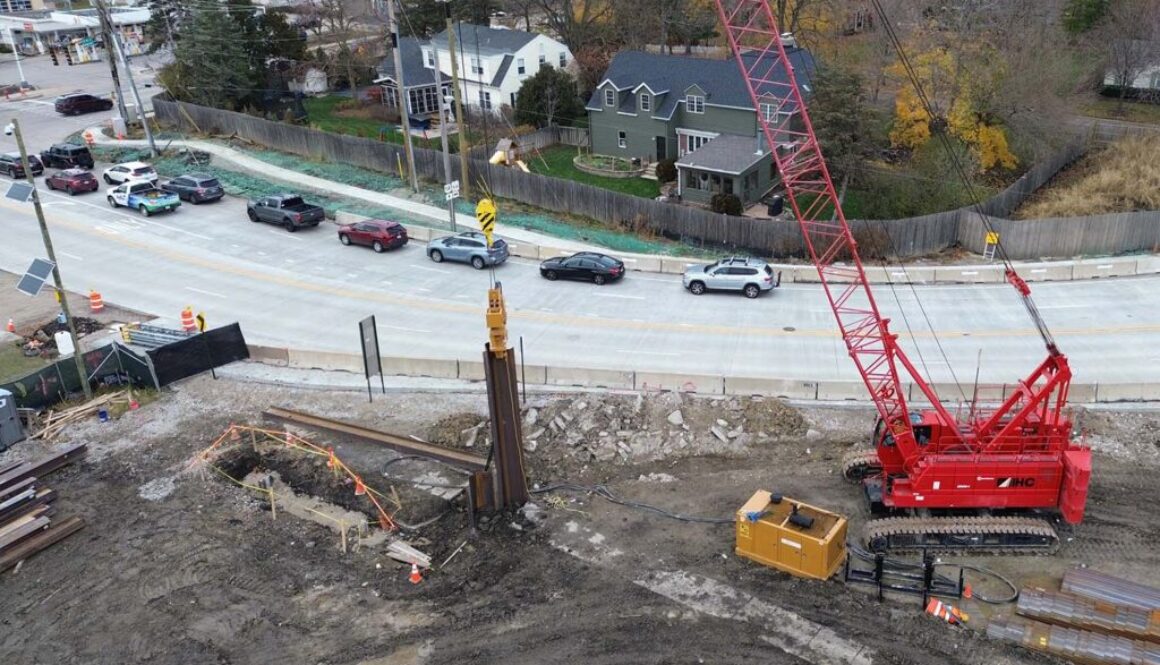

When the weather conditions permitted, construction activity continued through the winter months. Between January and March, crews completed the following work: Preparation for Permanent Sheeting […]

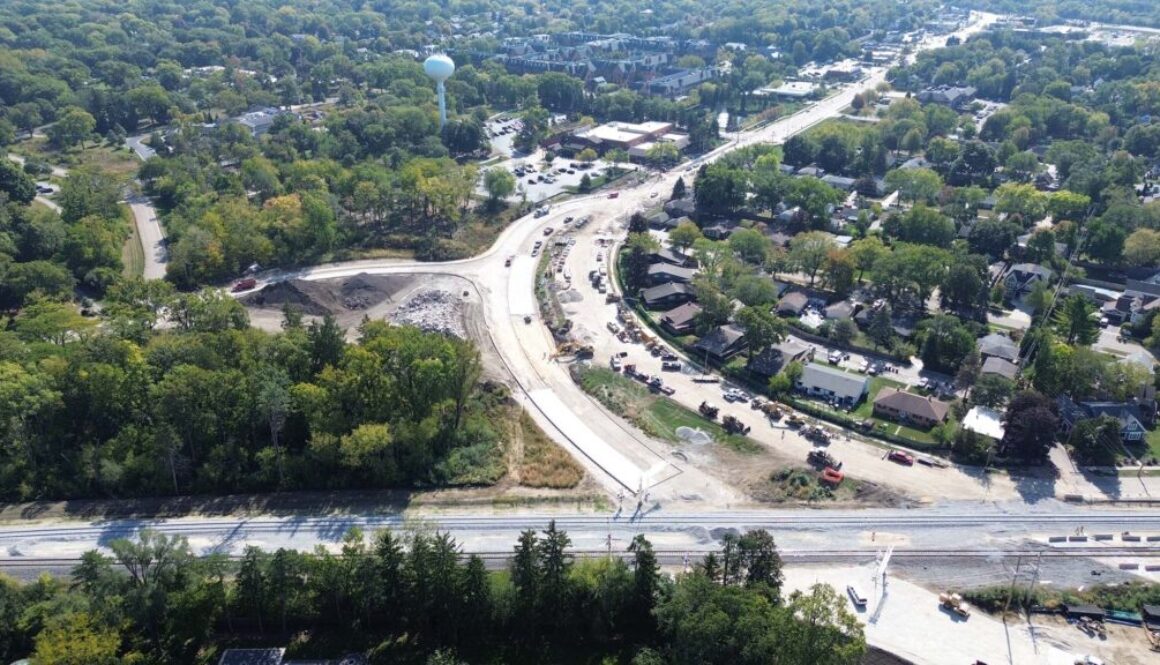

Construction activity has continued since Route 14 reopened on its new temporary four-lane roadway at the end of October. Over the past month, crews have […]

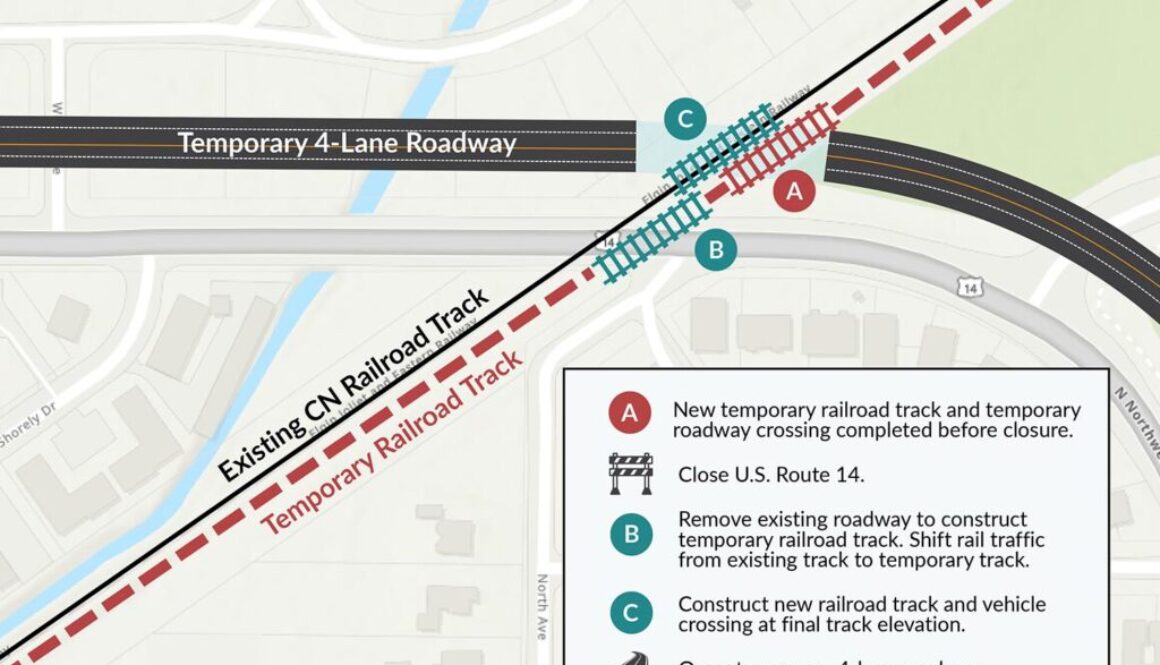

The Village of Barrington is excited to announce that Route 14 has officially reopened on its new temporary four-lane roadway, along with the temporary two-lane […]
Construction has been in full force to complete the temporary four-lane Route 14 roadway and the temporary two-lane Lake Zurich Road. Here’s what’s been happening […]
It has been a busy couple of weeks on the ground as we work towards opening up the temporary four-lane Route 14 roadway and the […]

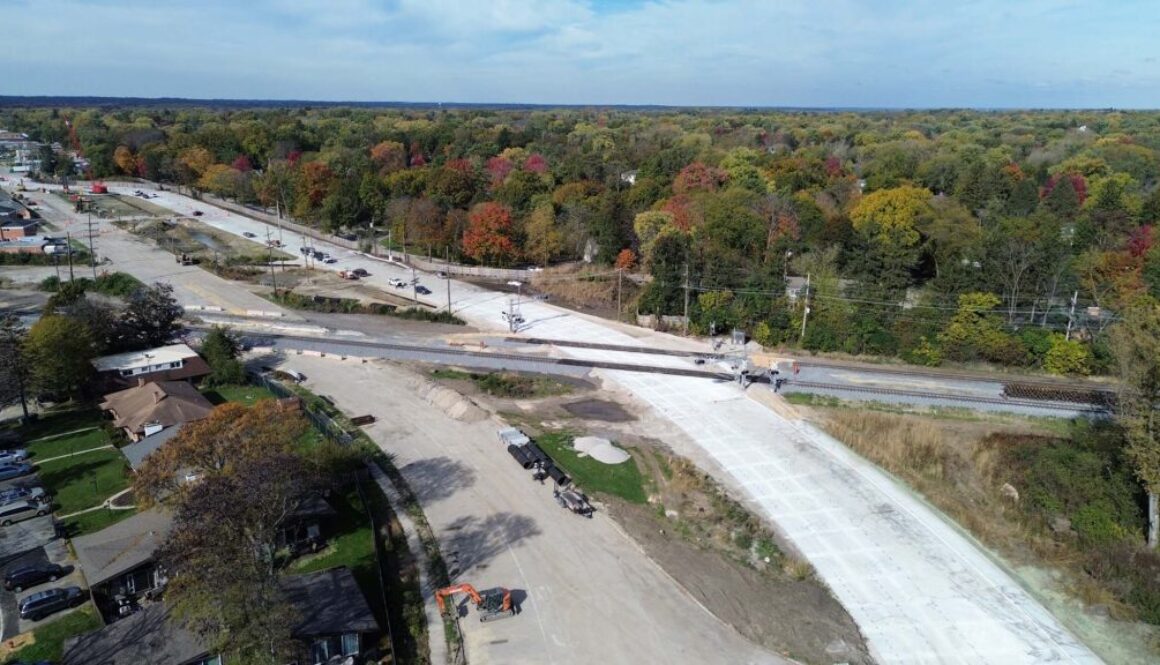

This past month, almost all of the temporary Route 14 roadway and temporary railroad track was completed. The current lane closures on Route 14 allowed […]
